What is site drainage in construction?

Site drainage is the system of slopes, channels, pipes and subsoil drains that collects rainwater and groundwater and moves it safely away from a building.

CollectRoof, paving and uphill runoff
ConveyFalls, channels, swales and pipes
DischargeSafe outlet plus overflow route

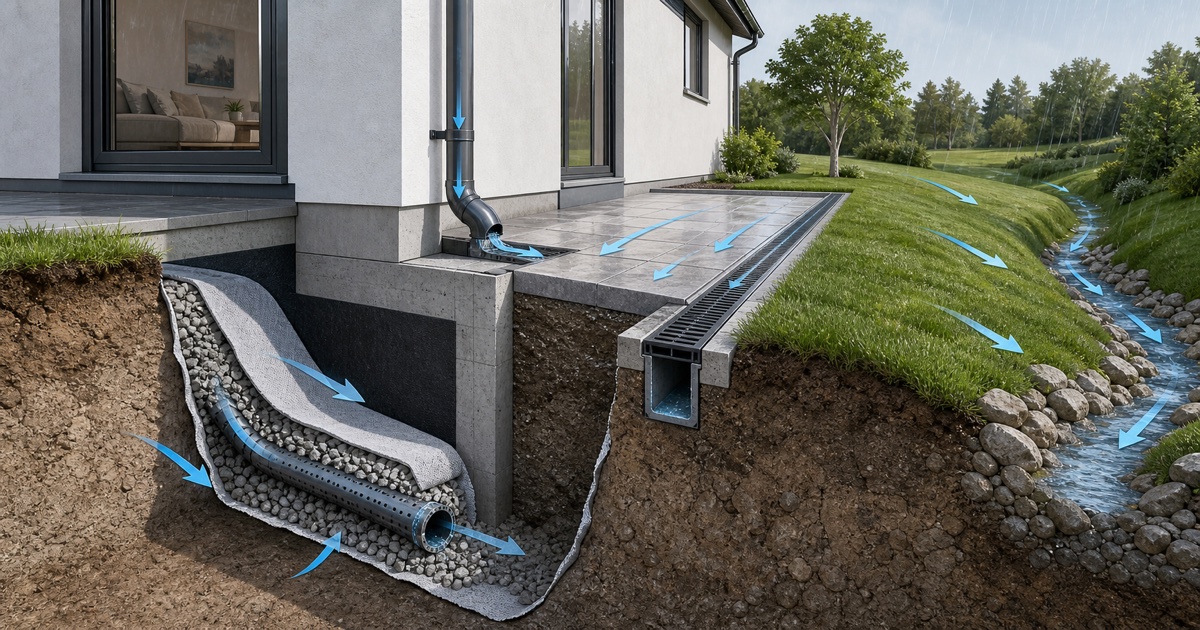

House site drainage showing surface falls, a trench drain, subsoil drain and safe outlet
Surface falls, collection, subsurface relief and a safe outlet must work as one maintainable system.

Key takeaways

Site drainage in one minute

BuildBudgeter technical editorial team Published 21 February 2026 · Updated 28 August 2026

Site drainage is a coordinated system that collects rainfall and shallow groundwater, keeps it away from the building, and discharges it through a safe, maintainable outlet. A complete design addresses three separate jobs: surface grading moves runoff away from walls, channels or pipes convey concentrated flow, and subsoil drains relieve water in the ground. Installing a French drain without confirming levels, soil permeability, an outlet and an overflow route is not a drainage design.

  • Start with levels. Water follows finished ground and pipe invert levels, not arrows on a concept plan.
  • Separate water sources. Roof runoff, paved runoff and groundwater may need different collection methods.
  • Design the outlet first. Every channel and pipe needs a legal discharge point plus a visible overflow route.
  • Keep it serviceable. Inlets, silt traps, inspection chambers and outlets must remain accessible after landscaping.

What is site drainage in construction?

In construction, site drainage means the permanent and temporary measures used to control water across a property. It covers roof water after it reaches ground level, runoff from paving and landscaped slopes, seepage through soil, and water that could collect beside foundations or retaining walls. The objective is not simply to hide water in a pipe. The objective is to collect it without damaging the building, convey it without erosion or blockage, and release or store it at a suitable location.

Surface drainage and subsurface drainage solve different problems. Surface measures include falls, swales, slot or trench drains, catch basins and open channels. Subsurface measures include perforated collector pipes, free-draining aggregate, geotextile filters and inspection points. Roof gutters and downpipes form another input to the same site-wide water route. The final arrangement depends on rainfall, catchment area, soil infiltration, groundwater, topography, finished floor levels, neighboring land and local discharge rules.

The practical test

A drainage plan should show where water starts, the level and route it follows, where it can be inspected, where it ends, and what happens when the normal route is temporarily overwhelmed or blocked.

System comparison

Types of site drainage and when they are used

No single drain type is best for every site. Good systems combine components according to the water source and the available outlet. The table below is a selection guide, not a substitute for hydraulic, geotechnical or local authority design.

Drainage measureBest used forMain design checkCommon failure
Grading and surface fallsMoving sheet flow away from walls, terraces and low pointsFinished levels continue to a safe collection point without reverse fallsLandscape or paving changes create a trapped low area beside the building
Trench or slot drainCollecting runoff across driveways, gates, thresholds and paved edgesGrate level, channel fall, outlet capacity and cleaning accessA narrow outlet pipe or silted channel becomes the bottleneck
Catch basin and solid pipeCollecting concentrated surface or roof flow and conveying it downhillSump depth, pipe invert, junction access and downstream dischargeDebris enters the pipe because no silt trap or removable basket is provided
French or subsoil drainIntercepting shallow groundwater and relieving wet soil beside structuresPerforated pipe level, clean aggregate, filter compatibility and a free outletThe pipe has nowhere to discharge or the filter clogs with fine soil
Swale or bioretention routeSlowing, conveying and sometimes infiltrating runoff in landscaped areasLongitudinal fall, erosion control, soil suitability and an overflow pathStanding water persists because infiltration was assumed rather than tested
Permeable pavingReducing runoff from suitable patios, paths and parking areasSubgrade permeability, storage layer, sediment control and underdrain needSurface and base clog because construction sediment was not controlled

The US Environmental Protection Agency describes swales as vegetated channels that transport water while slowing flow and supporting infiltration. It also notes that permeable pavement can store or infiltrate rainfall through underlying gravel, with an underdrain used where direct infiltration is unsuitable. These measures still need a site-specific overflow and maintenance plan.

Design workflow

How site drainage should be designed

  1. Map every water source.Mark roof catchments, downpipes, paved areas, uphill land, retaining walls, irrigation, springs and groundwater observations. Temporary construction runoff belongs on this map too.
  2. Survey controlling levels.Record finished floor, external threshold, paving, ground, wall footing, road drain and proposed outlet levels. Pipe gradients cannot be confirmed without invert levels at both ends.
  3. Define catchments and flow paths.Split the site into areas draining to each inlet or swale. Keep clean roof water separate from sediment-laden construction runoff where practical.
  4. Select and size components.Use local rainfall criteria and the contributing area to size channels, inlets, pipes, storage and overflows. FHWA's 2024 HEC-22 manual is a detailed reference for hydrologic and hydraulic drainage calculations, although local standards govern the project.
  5. Verify the discharge strategy.Confirm whether water may enter a public system, an approved outfall, storage, reuse or infiltration feature. Check downstream erosion, neighboring properties and the effect of high groundwater.
  6. Detail inspection and failure routes.Provide removable grates, sumps, cleanouts and chambers. Show where water will travel if an inlet blocks or a storm exceeds the normal design event.

Levels to coordinate before construction

ThresholdsExternal paving must not bridge waterproofing or direct runoff through doors.
Plinth and facadeFinished ground, splash exposure and drainage inlets must align with facade terminations.
FoundationsSubsoil drainage must not undermine founding soil or become a substitute for waterproofing.
UtilitiesDrain routes need coordinated crossings, separation and access around other buried services.

Numeric slopes are jurisdiction-specific. For example, Ontario's stormwater planning manual discusses maintaining at least a 2% grade within roughly 2 to 4 metres of a building, while explicitly directing designers to check local municipal standards. Treat that as an example of a published criterion, not a universal rule for every project.

Worked example

A sloping house site in a high-rainfall climate

Consider a hypothetical house with an uphill boundary, a paved terrace on one side and a garden falling toward a lower road. The first design move is not to place a French drain around the entire house. The team surveys the road connection, finished floor, terrace and garden levels, then separates three water sources: clean roof runoff, fast surface flow from the uphill side, and damp soil beside the uphill retaining condition.

A shallow swale intercepts uphill surface water before it reaches the building. The terrace falls to a removable trench drain with a silt sump. Roof downpipes connect to sealed pipes rather than discharging beside the foundation. A localized subsoil drain relieves the wet uphill zone and terminates at an inspection chamber. All routes continue to the confirmed lower outlet, while the garden surface forms a visible overflow path that stays below the internal floor level.

This arrangement is more robust than one hidden pipe because each component has one clear job and can be inspected. The example still requires rainfall sizing, soil assessment, structural coordination and approval of the discharge point. It demonstrates the decision sequence: source, level, collection, conveyance, outlet, overflow and maintenance.

Budget control

What changes site drainage cost?

Drainage cost is driven less by the name of a product than by excavation, levels, water volume, soil, access and the distance to a usable outlet. Early coordination can keep drainage within normal external works. Late discovery can trigger demolition of paving, deeper trenches, pumping, retaining-wall changes or off-site approvals.

Cost driverWhy it mattersEarly evidence to obtain
Flat site or high outletGravity drainage may require deeper excavation, storage or pumpingTopographic survey with outlet invert level
Clay, rock or high groundwaterExcavation, dewatering and infiltration assumptions changeGeotechnical observations and infiltration testing where relevant
Large roof and paved catchmentsPeak flow increases inlet, pipe, storage and overflow requirementsMeasured catchment plan and local rainfall criterion
Restricted site accessExcavation, spoil removal and aggregate delivery become less productiveLogistics plan and realistic plant access
Late landscape changesNew walls, planters and paving can block the designed flow pathCoordinated finished-level drawing before procurement
Unapproved dischargeRedesign may require detention, reuse, infiltration or another connectionWritten confirmation of the permitted outlet strategy

Construction check

Site drainage checklist before handover

  • Finished ground and paving visibly fall away from vulnerable walls and thresholds.
  • Every downpipe has a confirmed discharge route and does not empty beside the foundation.
  • Channel grates are removable and set below adjacent paving without creating a trip edge.
  • Catch basins include accessible sediment collection space where debris is expected.
  • Pipe inverts and gradients match the approved drawings and have been surveyed where concealed.
  • Subsoil drain aggregate and geotextile match the soil and specification.
  • Inspection chambers and cleanouts remain accessible after planting and hardscape completion.
  • Outlets are stable, legal and protected against erosion, backflow and animal entry where relevant.
  • The overflow route stays outside the building and does not transfer water to neighboring land.
  • A controlled water test confirms inlets, channels and outlets before final acceptance.
Warning signs after rain

Ponding beside walls, silt marks across paving, overflowing grates, damp retaining walls, soft landscape edges, erosion at outlets and persistent water in inspection chambers all justify investigation before finishes conceal the cause.

Primary references

Sources and scope

This guide explains coordination and selection principles. Project design must follow local rainfall data, building and stormwater rules, geotechnical advice and the approved discharge arrangement.

Used in project stages

Explore in the product

Related cost guides

See also

FAQ

What is site drainage in construction?

Site drainage is the coordinated system of ground falls, channels, inlets, pipes, swales and subsoil drains that collects rainwater and shallow groundwater, keeps it away from the building, and conveys it to a safe outlet.

What is the difference between surface drainage and subsurface drainage?

Surface drainage manages water visible on roofs, paving and ground using falls, channels, swales and inlets. Subsurface drainage uses permeable aggregate and perforated pipes to intercept water within the soil. Most complete site plans coordinate both.

Is a French drain enough for site drainage?

Not by itself. A French drain can relieve shallow groundwater, but it does not replace surface grading, roof-water collection, hydraulic sizing, a confirmed outlet, overflow planning or maintenance access.

When should site drainage be designed?

Drainage should be coordinated before foundation, facade, landscape and external paving levels are fixed. Late design often creates reverse falls, inaccessible drains, deep excavation or an outlet that cannot work by gravity.

What makes site drainage expensive?

Major cost drivers include a flat site, a high or distant outlet, large roof and paved catchments, clay or rock excavation, high groundwater, restricted access, pumping, storage requirements and late changes to finished levels.

How can site drainage be checked before handover?

Confirm surveyed levels and pipe inverts, keep grates and chambers accessible, inspect the approved outlet, clear construction sediment, and run a controlled water test through each collection and discharge route.
